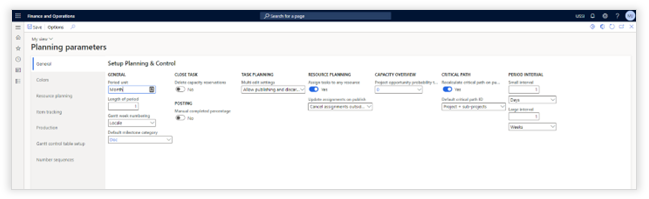

Setup and configuration

The Visual Planning parameters are in the following menu item: Production control > Setup > Planning & Control > Planning parameters

Graphical user interface, application

Description automatically generated

General

Parameter

Description

General

Period unit

This unit specifies the default planning horizon that will be shown from today on forward when a form is opened without any context.

Length of period

This length specifies the number of periods that will be shown from today on forward when a form is opened without context.

Gantt week numbering

It is possible to configure per legal entity the week numbering.

Locale: Setting the week numbering according to the user locale settings in Dynamics 365

ISO8601: Setting the week numbering according to the ISO8601 standard

US: Setting the week number according to the US standard

Default milestone category

(Only applies to Axtension Project Management)

Close task

Delete capacity reservations

When set to yes, the system will remove the capacity reservations for tasks that are marked as "closed". This will free up the resource to be assigned to a different task.

Posting

Manual completed percentage

(Only applies to Axtension Project Management)

Task planning

Activity planning method

(Only applies to Axtension Project Management)

Multi-edit setting

(Only applies to Axtension Project Management)

Resource planning

Assign tasks to any resource

When set to yes, a resource that has non-matching competencies can be assigned to a task after confirming a warning message. This feature allows the user to move a job or operation to an entirely different resource group or a resource that does not meet the resource requirements specified on the route.

Update assignments on publish

(Only applies to Axtension Project Management)

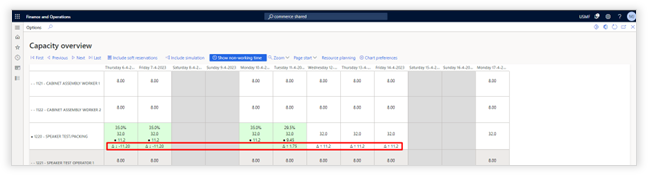

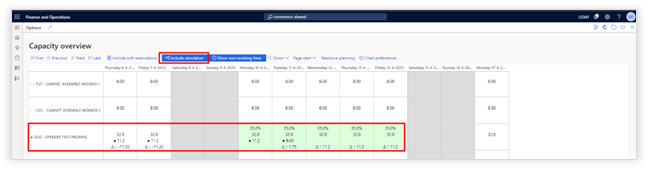

Capacity overview

Project quotation probability threshold

(Only applies to Axtension Project Management)

Critical path

Recalculate critical path on publish

(Only applies to Axtension Project Management)

Default critical path ID

(Only applies to Axtension Project Management)

Store all chains

(Only applies to Axtension Project Management)

Period interval

In both task- & resource planning the date range that is visualized can be adjusted by selecting two dates. These dates can be selected manually, or you can use the small & large intervals

Small interval

The small interval allows the user to change a date with a single click by days, weeks, or months.

Large interval

Graphical user interface

Description automatically generated with low confidence

The large interval allows the user to change a date with a single click by days, weeks, or months.

Sustainability

Bing Maps API Key

(Only applies to Axtension Project Management)

WBS

Convert predecessors

(Only applies to Axtension Project Management)

Configure task information

A screenshot of a computer

AI-generated content may be incorrect.

This allows for configuration of what information should be displayed on the job/operation, in the tooltip (when you hover over a task with your mouse) and on the description (show in the grid).

Parameter

Description

Type

Select for which type of order the setup should apply:
Production operation - an operation or job of a production order.

Planned production operation - an operation or job of a planned production order � result of MRP.

Information

Select where you would like to change the information shown:

Task description � The description of a task displayed in the grid on the left side of the screen.

Graphical user interface, application

Description automatically generatedTooltip � The description of job/operation when you hoover over a task.

Task name � The description shown in the Gantt bar

Configure description

Graphical user interface, text, application, email

Description automatically generatedSelect the fields that should be shown and sequence them with the up and down buttons.

Number of rows

See for more information Increase row heigt in resource planning.

Production icons

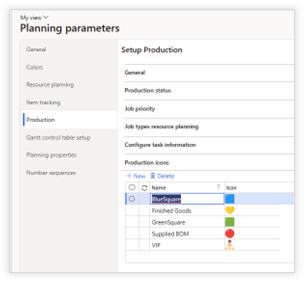

See for more information Configurable production icons and colors.

Graphical user interface, application

Description automatically generated

Colors

Parameter

Description

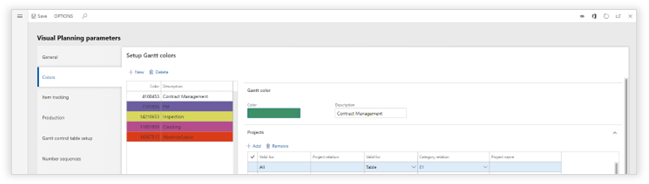

Gantt Color

Color

Define the color that should be applied to the activities that comply with the rules set up below.

Description

Provide a clear description that describes when this color is applied.

Projects

(Only applies to Axtension Project Management)

Production

Order Type

All: This color setting applies on all order types

Production order: This color only applies on production orders

Planned production order: This color only applies on planned production orders

Simulation order: This color only applies on production orders that are part of a simulation

Valid for > Production Group

All: This color setting applies to all production groups

Table: Production group: This color only applies to the selected group

Valid for > Production Pool

All: This color setting applies to all production pools

Table: Production pool: This color applies to the selected pool

Route/job type

The color applies to the selected route/job type. If left blank, it applies to all route job/types

Resource planning

(Only applies to Axtension Project Management)

Item tracking

Graphical user interface, application

Description automatically generated

Parameter

Description

Check item availability

Requirement fulfilled when

Physical reserved: the system will show that the items tracked on the BOM are available when the inventory is physical reserved and on-hand.
On hand in time: the system will show that the items tracked on a BOM are available at the required date of the operation.

On hand available physical: the system will show that the items tracked on a BOM are currently available.

Purchase / Production fulfilled when

Items will be shown as available when:
Complete: all items are (reserved and) on hand.
Part delivery: some of the items are (reserved and) on hand.

Automatically recalculate item availability

When set to Yes, the system will constantly validate automatically if the items linked to an activity via item tracking, are available.

When set to No, the validation of item availability needs to be manually initiated.

Plan for item tracking

When item availability is validated and there is no reservation, the master plan identified in this field will be used to check on "delay's".

Item requirements check

Default

(Only applies to Axtension Project Management)

Item requirement date update

(Only applies to Axtension Project Management)

Item requirements

(Only applies to Axtension Project Management)

Items

Item model group

Shows item model group

Automatically track

Select the item model groups that should be automatically set to "track in Visual Planning" on a BOM. Only items that are set to "track in Visual Planning" on the BOM are visualized.

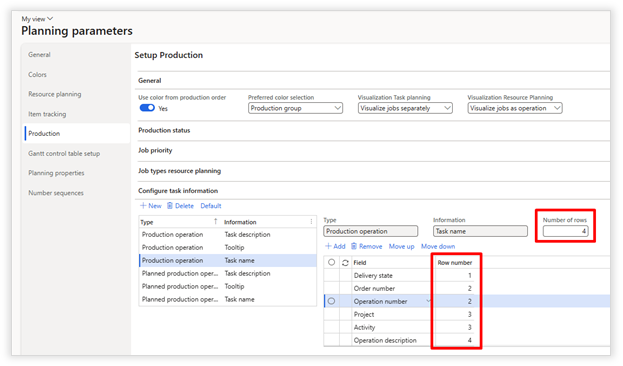

Production

A screenshot of a computer

AI-generated content may be incorrect.

Parameter

Description

General

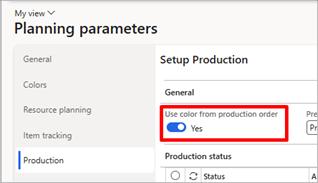

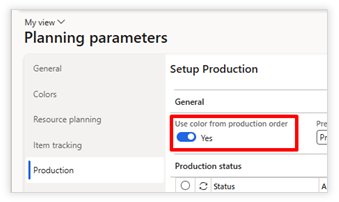

Use color from production order

No: Color defined in these parameters will be applied.

Yes: If there is a color specified on the production order, this color will be used for visualization. See for more information Configurable production icons and colors.

Preferred color selection

If there is a color configuration conflict, define which setting will get the preference.

Visualization Task planning

Visualize jobs as operation � If job scheduling is executed, the task will be visualized as a single bar in resource planning. In this scenario al jobs will remain attached to one another.

Visualize jobs separately � If job scheduling is executed, the jobs will be shown as individual tasks and can therefore individually be rescheduled.

Visualization Resource planning

Visualize jobs as operation � If job scheduling is executed, the task will be visualized as a single bar in resource planning. In this scenario al jobs will remain attached to one another.

Visualize jobs separately � If job scheduling is executed, the jobs will be shown as individual tasks and can therefore individually be rescheduled.

Production status

Status / Allow drag

Allow to reschedule a production order only when it complies to these configured statuses. All but reported as finished is best practice.

Job priority

Priority / Visible

Define which job priorities are shown in the resource planning. Within the task planning all job priorities are shown. Primary only is the preferred setup.

Job types resource planning

Route/job type, Visible

Define which job types should be shown during resource planning. Setup & Process time is best practice.

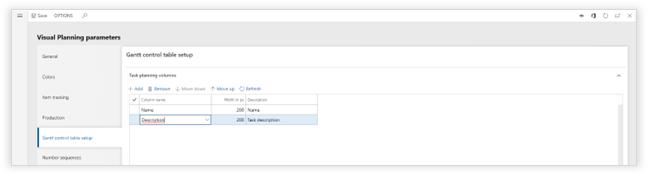

Gantt control table setup

Graphical user interface, text, application

Description automatically generated

Parameter

Description

Task planning columns

Column name

Activity field that should be displayed.

Width in px

Number of pixels that should be used to show the information.

Description

Description of the column name.

Visible columns

Specifies the number of displayed columns (more columns can be displayed by adjusting the width of the task planning columns.

Resource planning columns

Column name

Activity field that should be displayed.

Width in px

Number of pixels that should be used to show the information.

Description

Description of the column name.

Visible columns

Specifies the number of displayed columns (more columns can be displayed by adjusting the width of the resource planning columns.

Task Planning

Open the task planning

The task planning for the (planned) production jobs and operations can be opened in 2 ways:

1: Generic task planning

Navigate to Production control > Planning for production > Task planning

The task planning will show all (planned) production jobs and operations within the configured date range from the chart preferences.

2. Task planning for selected production orders

Navigate to Production control > Production orders > All Production orders
Select the production orders that need to be shown in the task planning. The production jobs and operations for the selected production orders are shown within the task planning. �
After selecting the production orders, the task planning can be opened by using the ribbon
action Planning for production > View > Task planning

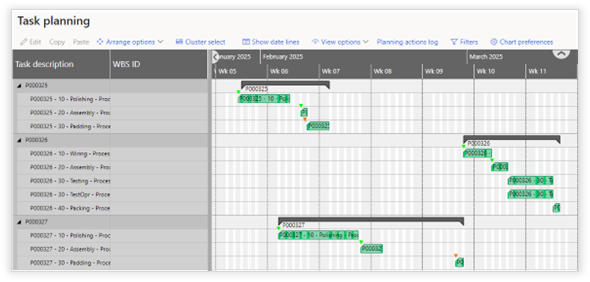

How to use the task planning

The task planning - all available actions

Below a description of all available actions in the task planning.

Please note that based on how the task planning is opened (1. Generic resource planning or 2. Task planning for selected production orders) some actions might be unavailable.

Function

Description

Edit

Show production operation/job information.

Copy

Copy the selected task(s).

Paste

Paste the copied task(s) below the selected task in the task planning.

Arrange options (drop-down)

Add selection to a cluster

Adds the selected tasks to a cluster. You can add tasks to an existing cluster, merge and split clusters. When "show clusters" is enabled, the system will automatically select all operations/jobs when the selected operation/job is part of a cluster. This allows easy rescheduling for a group of operations and jobs.

Delete from cluster

Removes the selected tasks from a cluster. To remove a singly task from a cluster, first make sure the "show clusters" is disabled otherwise the system will automatically select the entire cluster.

Cluster

Go to the form in which a list of all clusters is shown. Here you can change the color coding, and the description applied to the clusters.

Cluster select

When enabled: The Gantt will highlight other tasks that are included in the same cluster as the selected task.

When disabled: The Gantt will not display any clustering information.

Show date lines

When this toggle is enabled, the system will show lines representing the start date and time of the first operation, the end date and time of the last operation and the requirement dates from the pegging information.

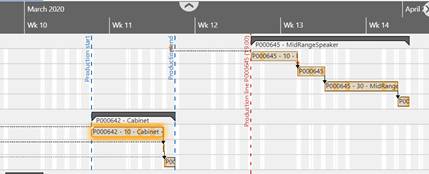

The production order lines are blue.

Requirement lines are red.

Graphical user interface

Description automatically generated with low confidence

View options (drop-down)

Zoom in

Change the scaling of the entire Gantt. Zoom in, increases the readability.

Zoom out

Change the scaling of the entire Gantt. Zoom in, decreases the readability.

Reset Zoom

Set the zoom level adjusted with the zoom in & zoom out to default.

Fit into view

Show the entire planning horizon in a single view. This changes the scaling automatically.

Scroll to today

Independent of the scaling, move the view to today.

Hide non-working time

When enabled: the task planning will also display dates & times in which there is no capacity according to the calendar.

When disabled: the non-working time defined in the calendar will not be displayed in the task planning.

Planning actions log

Logging

Display the actions for all users or the actions for the current user.

My logging: Displays actions for the current user.

All: Displays actions for all users.

Logged action

The left pane displays the sequence of all actions and provides the option to show an action individually.

Comment

Ability to enter additional information on an action.

Lines

Overview of all orders and operations affected by the action.

Line details

Overview of the changes in time and/or resource on the affected lines.

Undo last

Action to undo the latest action in the sequence. It is not possible to undo a task other than the latest. A user can only undo changes made by the user.

Filters

Saved views

When a filter is created, this filter can be stored as a view. Within this dropdown you can easily select predefined views. When saving a view, it can be marked as "private". In this situation the filter will not be visible to others in the organization.

Filters

All filters specified in the selection criteria are "AND" filters. This means the remaining jobs and operations need to comply to all criteria.
Please note that filters can be displayed based on the chart preferences. If e.g. the "Item tracking" icon is enabled in the chart preferences the filter "Material status" becomes available in the "Filters" form. ��

Chart preferences

From

"From" date selection used in the task planning (intervals can be changed in the Planning parameters)

To

"To" date selection used in the task planning (intervals can be changed in the Planning parameters).

Lock the period duration, allows the user to simultaneously move the "from" and "to" date when using the small & large interval buttons.

Show tasks

Active: Tasks that have not yet been closed.
All:
Active and closed tasks.

Show item tracking

Show the item tracking icon based on the material status.

Projects

Show projects

Current: Show projects for the current legal entity.

Intercompany: Show intercompany projects.

Include subprojects

Show the activities subprojects.

Quotations

Show the activities from project quotations.

Show resource availability

Show the resource availability for project activities.

Show estimated planning status

Show the estimated planning status for project activities.

Show budget status

Show the budget status for project activities.

Production

Production orders

Show the operations and jobs for production orders.

Planned production orders

Show the operations and jobs for planned production orders.

Site

Filter (planned) production orders on site.

Master plan

Show (planned) production orders based on this master plan.

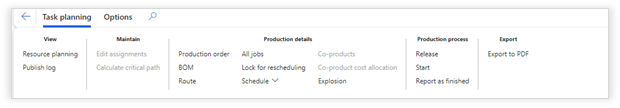

The task planning - actions in the ribbon

A description of all available actions in the ribbon can be found below.
Please note that based on how the task planning is opened (1. Generic resource planning or 2. Task planning for selected production orders) some actions might be unavailable. The most important actions from the ribbon are also available as right click mouse actions.

Action

Description

View

Resource planning

Open the resource planning for the selected production order(s).

Capacity overview

Open the capacity overview for the selected production resources.

Publish log

(not applicable).

Maintain

Edit assignments

Edit the selected assignment.

Calculate critical path

Calculate the critical path for the project setup.

Production details / Planned production

Show all details of the selected job/operation like the BOM, Route and Explosion.

Production process

Release

Release the production order for the selected operation(s) or job(s).

Start

Start the selected operation(s) or job(s).

Report as finished

Report the selected operation(s) or job(s) as finished

Export

File name

Ability to adjust the generated file name.

Page format

Ability to choose the desired page format.

Page orientation

Ability to choose the desired page orientation.

Print mode

Single page: the selected task- and/or resource planning will be exported to a single page.

Cutting marks: the selected task- and/or resource planning will be exported to multiple pages (based on page format and orientation), as each page being part of the total plan.

Paging: the selected task- and/or resource planning will be exported to multiple pages (based on page format and orientation), including the columns on each page.

The task planning - icons and colors

Visualization

Description

Visualization of operations / jobs

Item tracking on operations / jobs

         Orange: Planned - Materials are not available but are expected to arrive on time.

         Red: Delayed - Materials are not available on time.

         Green: Available - Materials are available either on hand or on hand and reserved, depending on the parameter.

         Blue: Picked - Items have been picked, but not yet consumed.

         Grey: Consumed - Materials have been consumed on production order.

Manually locked for rescheduling. The operation or job can't be rescheduled.

Operations / jobs are included in a simulation. Operations / jobs that are included in a simulation can't be rescheduled via the task planning. Operations / jobs that are included in a simulation can be rescheduled via the simulation.

Resource planning

Open the resource planning

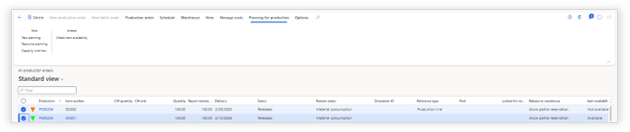

The resource planning for the (planned) production jobs and operations can be opened in 2 ways:

1: Generic resource planning

Navigate to Production control > Planning for production > Resource planning

The resource planning will show all (planned) production jobs and operations according to the criteria from the resource selection form. This form is automatically shown when opening the resource planning.

Below an overview of all available criteria from the "Resource selection" form can be found:

Fields

Description

Saved views

Select view

You can save the selected resources as a view. The dates will not be stored as part of a view. When a view is marked as private it will not be visible to the rest of the organization.

Dates

Use relative dates

If toggle set to no, select the start & end date manually
If toggle set to yes, select a number of periods to the past and a number of periods to the future. The system will dynamically detirmine the selected dates. Relative dates will be saved in "saved views".

Equipment

Equipment selection type

Resource � Allows to select both resource groups as resources.
Resource groups � Allows only to select resource groups.

Equipment

Selection of the resource groups that need to be shown in the resource planning. The resources are defined in: Organization administration > Resources > Resource groups.

NOTE: If the equipment selection type is set to "Resource" you have full flexibility in selecting the resources and determining the order. This could result in a resource group and a resource shown without a logical relation.

2. Resource planning for selected production orders

Navigate to Production control > Production orders > All Production orders

Select the production orders that need to be shown in the resource planning. The production jobs and operations for the selected production orders are shown within the resource planning. �
After selecting the production orders, the resource planning can be opened by using the ribbon
action Planning for production > View > Resource planning

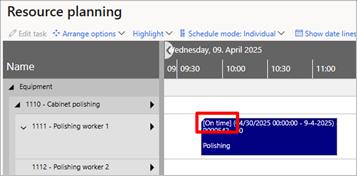

The resource planning is opened based on the start and end date of the selected (planned) production orders.

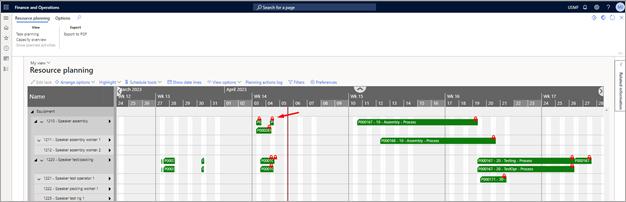

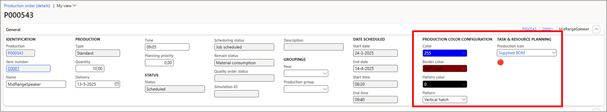

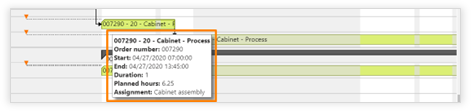

A screenshot of a computer

Description automatically generated

How to use the resource planning

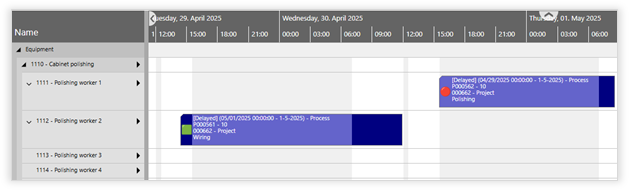

The resource planning � all available actions

Timeline

Description automatically generated

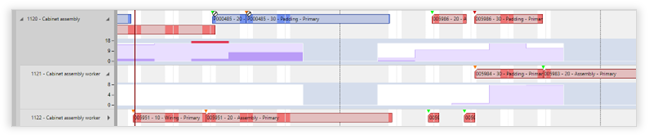

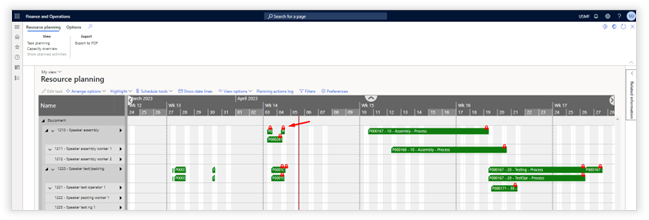

An overview of all available actions can be found below. Note that not all actions will be available depending on how the resource planning is opened and what information is shown. �

Action

Description

Edit task

Show the details of the selected operations/jobs

Arrange options (drop-down)

Snap

When enabled: The operation will automatically snap to another operation.
When disabled: The operation will snap to another operation, which could potentially create a capacity gap or an overlap between operations.

Connect selection

Connect all selected jobs/operations to one another in the selected sequence. The result is a perfectly scheduled resource with no capacity gaps.

Connect next

Connect the next job/operation of the same order to the selected job/operation

Connect previous

Connect the previous job/operation of the same order to the selected job/operation

Add selection to a cluster

Adds the selected tasks to a cluster. You can add tasks to an existing cluster, merge and split clusters. When "show clusters" is enabled, the system will automatically select all operations/jobs when the selected operation/job is part of a cluster. This allows easy rescheduling for a group of operations and jobs.

Delete from cluster

Removes the selected tasks from a cluster. To remove a singly task from a cluster, first make sure the "show clusters" is disabled otherwise the system will automatically select the entire cluster.

Cluster

Go to the form in which a list of all clusters is shown. Here you can change the color coding, and the description applied to the clusters.

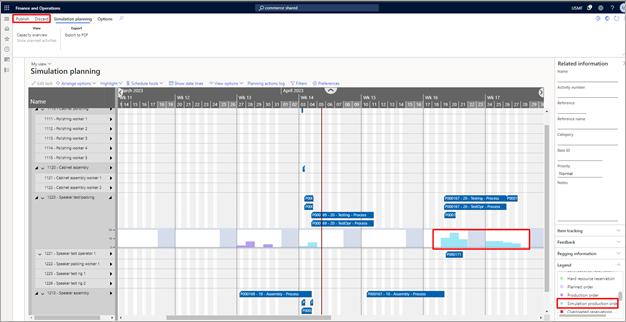

Reschedule based on progress

When progress is posted to a job or operations, this feature allows to automatically reschedule the operation/job to "now", based on that progress.

Example: A production order that takes 8 hours and should have been completed yesterday, has only 4 hours of progress. When selected and rescheduled based on progress, the system will reschedule the remaining 4 hours from now forward.

Highlight (drop-down)

Order

When enabled, the system will highlight all operations belonging to the same production order.

Referenced

When enabled, the system will highlight all referenced operations.

Disabled

No operations are highlighted

Schedule Mode (drop-down)

Individual

The Gantt will select all related jobs in the order of the selected job.

When disabled, The Gantt will select only the selected job.

Order

The Gantt will select all related jobs in the same production order and schedule the whole order.

Referenced

The Gantt selects all jobs of referenced production orders and allows to schedule all production orders.

Cluster select

The Gantt will highlight other tasks that are included in the same cluster as the selected task.

Show date lines

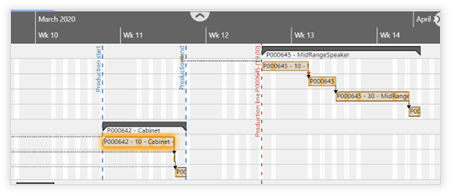

When this toggle is enabled, the system will show lines representing the start date and time of the first operation, the end date and time of the last operation and the requirement dates from the pegging information.

The production order lines are shown in blue.

Graphical user interface

Description automatically generated with low confidenceRequirement lines are shown in red.

View options

Zoom in

Change the scaling of the entire Gantt. Zoom in, increases the readability.

Zoom out

Change the scaling of the entire Gantt. Zoom out, decreases the readability.

Reset Zoom

Set the zoom level adjusted with the zoom in & zoom out to default.

Fit into view

Show the entire planning horizon in a single view. This changes the scaling automatically.

Scroll to today

Independent of the scaling, move the view to today.

Non-working time

When enabled, the Gantt will also display time frame in which there is no capacity according to the calendar.
When disabled, the non-working time defined in the calendar will not be displayed in the Gantt.

Pin

The selected resource will be pinned at the top of the screen. This way, when scrolling through the resource list, the pinned resource will remain visible. The pinning of resources is only remembered for a single session, when reopening the screen, the pinning of resources will be gone.

Unpin

Unpin a previously pinned resource.

Planning actions log

Logging

Display the actions for all users or the actions for the current user.

My logging: Displays actions for the current user.

All: Displays actions for all users

Logged action

The left pane displays the sequence of all actions and provides the option to show an action individually.

Comment

Ability to enter additional information on an action.

Lines

Overview of all orders and operations affected by the action.

Line details

Overview of the changes in time and/or resource on the affected lines.

Undo last

Action to undo the latest action in the sequence. It is not possible to undo a task other than the latest. A user can only undo changes made by the user.

Filters

Saved views

When a filter is created, this filter can be stored as a view. Within this dropdown you can easily select predefined views. When saving a view, it can be marked as "private". In this situation the filter will not be visible to others in the organization.

Filters

All filters specified in the selection criteria are "AND" filters. This means the remaining jobs and operations need to comply to all criteria.

Preferences

From

From date selection for the resource planning (intervals can be changed in the Planning parameters)

To

To date selection for the resource planning (intervals can be changed in the Planning parameters)

Lock the period duration, allows the user to simultaneously move the "from" and "to" date when using the small & large interval buttons.

Show tasks

Active: Show the active tasks.
All:
Active and closed tasks.

Show all tasks for resource

When set to Yes, For the resources in the resource planning, all tasks will be shown (including other Production orders).

When set to No, only tasks applicable to this Production order will be shown.

Show item tracking

Show the item tracking icon based on the material status.

Projects

(Only if Axtension Project Management is licensed)

Show Projects

If set to yes, project tasks assigned to the selected resources will be shown.

Quotation

If set to yes, project quotation tasks assined to the select resources will be shown

Show resrouce availability

Show the resource availability for project activities.

Show estimated planning status

Show the estimated planning status for project activities.

Production�

Production orders

Show related production orders and their planning

Planned production orders

Show related planned orders and their planning

Master plan

Show planned production orders based on this master plan

The resource planning � actions in the ribbon

An overview of all available actions can be found below. Note that not all actions will be available depending on how the resource planning is opened and what information is shown.�

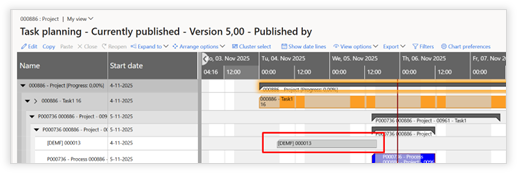

Graphical user interface, text, application

Description automatically generated

Action

Description

View

Task Planning

Open the task planning of the project that belongs to the selected order.

Capacity overview

Open the capacity overview for the project that belongs to the selected order resources.

Show planned activities

Show all planned activities for the selected resource.

Edit

Task planning

Show the task planning for the selected operation.

Planned production

Additional details for the selected job/operation like the BOM, Route and Explosion.

Lock for rescheduling

Lock full production order for rescheduling.

Lock operation for rescheduling

Lock individual jobs or operations for rescheduling.

Production process

Release

Release the full production order for the selected operations or jobs.

Start

Start the selected operations or jobs.

Report as finished

Report the selected operations or jobs as finished.

Resource assignments

(Only if Axtension Project Management is licensed)

Assign resources to project tasks that are visualized in the resource planning.

Selection

Resources

Open the resource selection pane to change the resource selection of the currently visualized orders.

Export

File name

Ability to adjust the generated file name.

Page format

Ability to choose the desired page format.

Page orientation

Ability to choose the desired page orientation.

Print mode

Single page: the selected task- and/or resource planning will be exported to a single page.

Cutting marks: the selected task- and/or resource planning will be exported to multiple pages (based on page format and orientation), as each page being part of the total plan.

Paging: the selected task- and/or resource planning will be exported to multiple pages (based on page format and orientation), including the columns on each page.

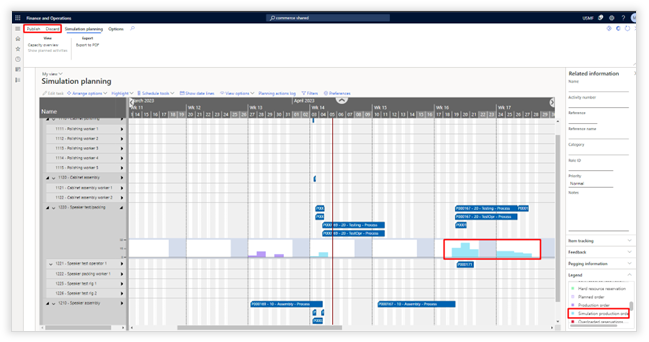

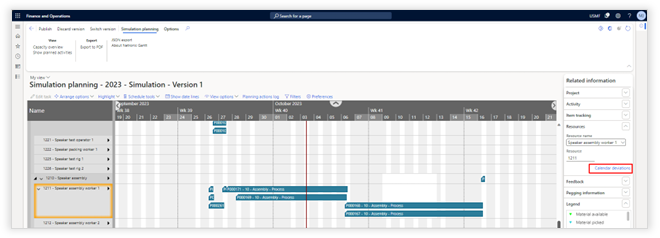

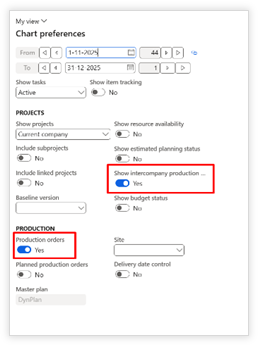

Visualize intercompany production orders

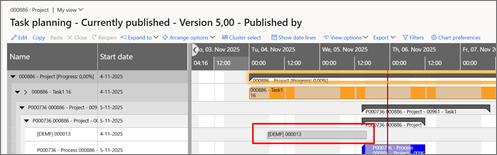

A screenshot of a computer screen

AI-generated content may be incorrect.Axtension Production Planning can visualize intercompany production orders exploded out of a project related production order.

The visualization is added to the task planning of Axtension Project Management.

To visualize an intercompany production order, open the task planning of Axtension Project Management and enable the Production order toggle and the Show intercompany production order toggle.

Enabling the Show intercompany production orders toggle will show intercompany production orders in the project task plan with the total duration of the production order and with the legal entity code as a prefix.

A screenshot of a computer

AI-generated content may be incorrect.

Note: Intercompany production orders are visualized from the start date until the end date of the production order. Individual operations of production orders are not visualized.

�The resource planning - icons and colors

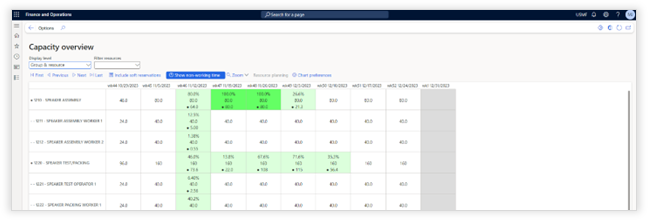

A picture containing graphical user interface

Description automatically generated

Visualization

Description

A screenshot of a computer

Description automatically generated

Resource Group

Resource

A screenshot of a computer

Description automatically generated

Expanded resource group histogram

Expanded resource histogram

A purple and white rectangles

Description automatically generated

A white circle with black background

Description automatically generated,A black and white play button

Description automatically generated,A white circle with a black stripe in it

Description automatically generated

Task status:

Can be started, predecessors are completed completed or there are no predecessors.

Is started

Should not be started, predecessors are not completed.

A black background with a black square

Description automatically generated with medium confidence

Operation or job locked for rescheduling

Operations / jobs are included in a simulation. Operations / jobs that are included in a simulation can't be rescheduled via the resource planning. Operations / jobs that are included in a simulation can be rescheduled via the simulation.

Cluster color, in the right corner of the operation(s)/job(s) the cluster color is displayed.

BOM requirement

Increase row height in resource planning

To improve readability and comprehensibility of the operations and jobs information in the resource planning, it is now possible to set the numbers of rows on the task name and what information needs to be shown per row.

A screenshot of a computer

AI-generated content may be incorrect.

Configuring the operation and jobs information in the resource planning can be done in the "Planning parameters" on the "Production" tab.

To configure the number of rows and what information needs to be shown, select the "Production operation" or "Planned production operation" in the "Type" column and "Task name" in the "Information" column. The "Number of rows", add the "Fields that need to be displayed and assign the "Row number" to determine the orders.�

A screenshot of a computer

AI-generated content may be incorrect.

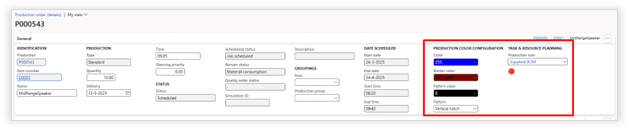

Configurable production icons and colors

Distinguished colors and icon can be assigned to released products and individual production orders for easy identification of a product and it's production order.

On a released product the following can be configured:

-          Color of the bar

-          The color of the bar border

-          The desired patern and color of the bar

-          A specific icon for an item

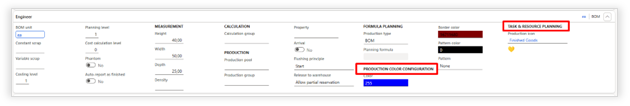

On the "Engineer" fast tab on a released product the colors and icon can be configured:

A screenshot of a computer

AI-generated content may be incorrect.

The defaults from a released product will be applied automatically on a new production order, but can be adjusted on the production order if needed:

Once applied the colors, pattern and icon will be shown in the resource planning.

A screenshot of a computer

AI-generated content may be incorrect.

A blue and white barcode with white numbers

AI-generated content may be incorrect.

To use the colors from released products and production orders the option "Use color from production order" needs to be enabled in the "Planning parameters" on the "Production" tab.

A screenshot of a computer

AI-generated content may be incorrect.

Icons can be added in the "Planning parameters" on the "Production" tab. Add a label and select the desired icon(s) from the predefined icon list.

A screenshot of a computer

AI-generated content may be incorrect.

After creating the production icon(s), the created production icon(s) can be selected on a released product and production order.

Sequence operations based on properties

To optimize operation sequencing, it is now possible to set up planning properties which can be assigned to specific operations of a released product route. By setting such planning properties, operations can be clustered in a production simulation to optimize resource utilization by avoiding redundant setup times.

An example could be a required oven temperature for an operation.

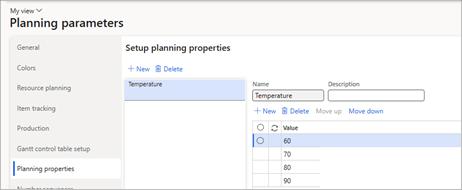

First step is to define a planning property with its values and the order of the values, which will define how the operations are sequenced. The planning properties can be configured in the "Planning parameters" on the "Planning properties" tab.

A screenshot of a computer

AI-generated content may be incorrect.

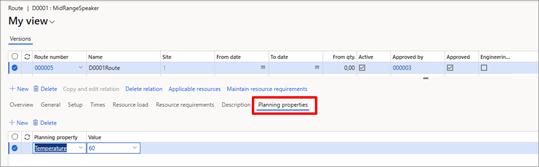

Once a planning property has been set up, the route of a released product can be configured by assigning a planning property to one or more operations. This can be done by navigating to the "Planning properties" tab on an operation.

A screenshot of a computer

AI-generated content may be incorrect.

Next step is to apply the planning property to either a resource group or individual resources.

A screenshot of a computer

AI-generated content may be incorrect.

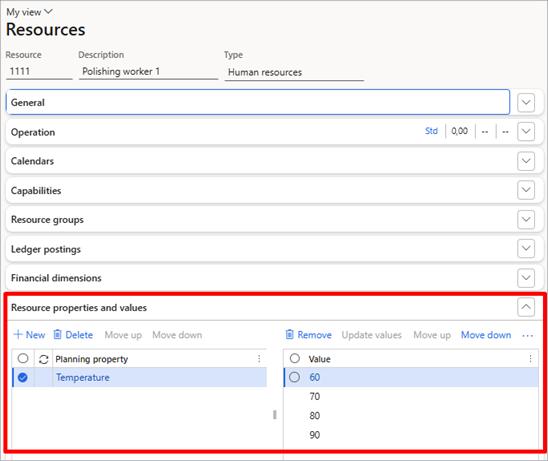

On the resource group and resource, a new fast tab "Resource properties and values" is added. The required planning property or planning properties can be selected while also having the ability to finetune the values in the correct order.

Once a planning property is assigned to a resource group or resource, a new arrange option will become available in a production simulation.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a phone

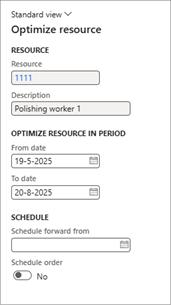

AI-generated content may be incorrect.Selecting "Optimize" will show a form in which the user can:

-          Select the period in which operations need to be optimized

-          Starting date from which operations will be scheduled forward

-          Ability to reschedule the whole order of affected operations

After selecting "Ok", operations in the defined period are rescheduled following the planning property order as defined on the resource group/resource.

Rescheduled operations are also automatically added to a cluster in the simulation for easy identification of optimized operations.

Publishing the simulation will ultimately update the new schedule for the rescheduled operations.

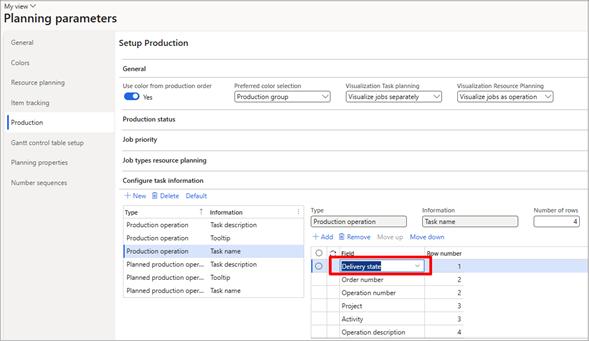

Delivery date control

The delivery state field shows the value "On time" or "Delayed". If the production end date is scheduled before the first requirement date, it will be shown as on time. If scheduled after the first requirement date, it will be shown as delayed.

A screenshot of a computer

AI-generated content may be incorrect.

This field can be used on the task description, tooltip and task name in the resource planning.

A screenshot of a computer

AI-generated content may be incorrect.

In addition, a new management by exception filter is introduced to filter production orders on the delivery state.

A screenshot of a computer

AI-generated content may be incorrect.

Capacity overview

Open the capacity overview

The capacity overview be opened in 2 ways:

1: Generic capacity overview

Navigate to Production control > Planning for production > Capacity overview

Graphical user interface, application

Description automatically generated

The capacity overview form will show all capacity loads that comply with the selection criteria provided in the resource selection form.

Below, an overview of the available criteria from the resource selection form can be found

Field

Description

Saved views

Select view

You can save the selected resources as a view. The dates will not be stored as part of a view. When a view is marked as private it will not be visible to the rest of the organization.

Dates

Use relative dates

If toggle set to no, select the start & end date manually
If toggle set to yes, select a number of periods to the past and a number of periods to the future. The system will dynamically detirmine the selected dates. Relative dates will be saved in "saved views".

Equipment

Equiptment

Selection of resource groups. These are the resources defined in: Organization administration > Resources > Resource groups

2. Task planning for selected production orders

Navigate to Production control > Production orders > All Production orders
Select the production orders that need to be shown in the capacity overview. The capacity overview will show all capacity loads for resources assigned to the orders. After selecting the production orders, the capacity overview can be opened by using the ribbon action Planning for production > View > Capacity overview.

How to use the capacity overview

With the "Resources" action in the ribbon the selected resources can be changed. �

Below an overview can be found of all available action within the capacity overview:

A screenshot of a computer

Description automatically generated

Action

Description

Display level

Toggle between:

-       Showing only resource groups

-       Individual resources

-       Combination of group and resources

Filter resources

Show all resources or the resources which are overloaded.

First

Go to the first page (See the "Page start" drop-down for the available periods)

Previous

Go to the first page (See the "Page start" drop-down for the available periods)

Next

Go to the first page (See the "Page start" drop-down for the available periods)

Last

Go to the first page (See the "Page start" drop-down for the available periods)

Include soft reservations

Include the hours from planned production orders when calculating the resource utilization percentage.

Include posted hours

Include posted hours when calculating the resource utilization percentage

Show non-working time

If highlighted each period that contains no capacity will be shown for the selected roles and resources. If not highlighted all periods will be shown. �

Zoom

Show the capacity overview per day, week, month or quarter.

Page start

Navigate to the desired timeframe. The screen will by default show a maximum of periods. This drop-down helps navigate through these multiple pages.

Resource Planning

When one of the capacity cells has been selected, the resource planning button will become available. This will open the resource planning for the selected resource, the selected role and the selected cell's period + the period before and after.

Chart preferences

Start date

Set start of date range selection.

End date

Set end of date range selection.

Plan

(only available when Visual Planning for Production is licensed)

Below an overview of all colors and visualizations can be found:

Function

Description

A white background with black and white clouds

Description automatically generated with medium confidence

No Capacity

A number on a white background

Description automatically generated

No Capacity demand

A close-up of numbers

Description automatically generated

Partial capacity demand

A green screen with numbers and a dot

Description automatically generated

Full capacity demand

A pink background with black numbers

Description automatically generated

Lightly overloaded capacity demand

A pink background with numbers

Description automatically generated

Overbooked capacity demand

Hard reserved (Production orders) / Soft reserved (Planned orders)

The resource role

The resource

Production planning simulation

How to open the production planning simulation

Production simulation can be opened via Production Control > Planning for production > Simulation planning.

Creating and using a production planning simulation

With the "New simulation" form the period and site must be selected, to determine which production orders will be included in the simulation.

Graphical user interface

Description automatically generated

Graphical user interface, application

Description automatically generated with medium confidence

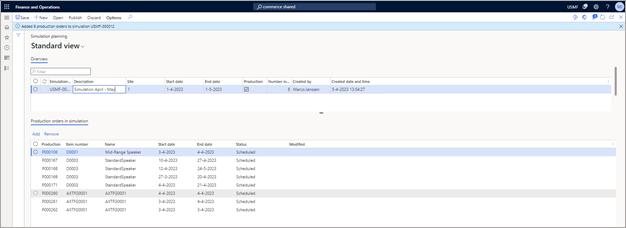

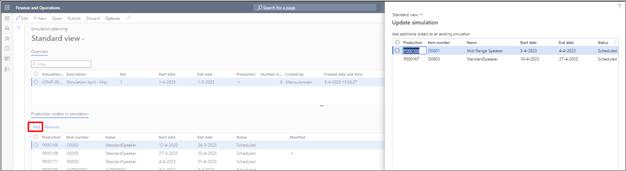

Production orders can be added or removed to a planning simulation. The "Add" action will show production orders which are not already part of the simulation and are scheduled between the start and end dates of the selected simulation.

Graphical user interface, application, Teams

Description automatically generated

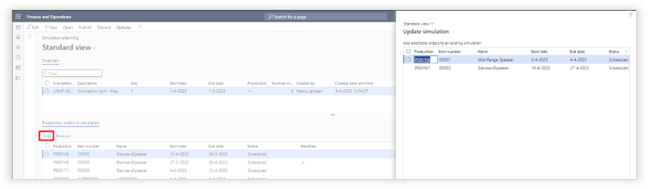

By using the "Open" action, the simulation planning of the selected production orders will be displayed in the resource planning.

The simulation planning provides the ability to move production orders in time or assign them to another resource which are part of the simulation.

This provides the ability to determine the best possible production planning, while not adjusting the actual production planning.

Simulation planning can show the familiar histogram of resource group(s) and resource(s) but adds the insight of a blue indicator showing the impact of the simulation planning on the capacity of the selected resource group/resource.

The actions Publish and Discard will apply the simulation planning or delete the simulation planning.

Graphical user interface, timeline

Description automatically generated

Familiar scheduling tools from the Axtension Production resource planning are available in the new simulation planning.

Graphical user interface

Description automatically generated with medium confidence

Production orders that are part of a simulation are displayed with a red lock icon in the Axtension Production resource planning.

Production orders part of a simulation are displayed via the simulation ID in the "All production orders" list page.

Graphical user interface, application, table

Description automatically generated

Changes applied according to the simulation planning are noted in the planning action log of the resource planning and can be undone completely if necessary.�

Graphical user interface, table

Description automatically generated

Apply production planning simulation on resource capacity

It is possible to open the capacity overview from the simulation planning and understand the impact of the simulated planning on the resource group(s) and resource(s).

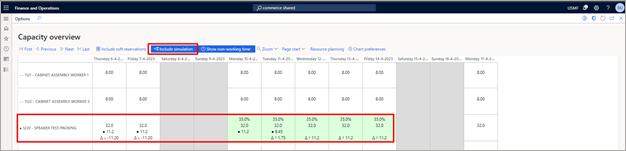

A picture containing calendar

Description automatically generated

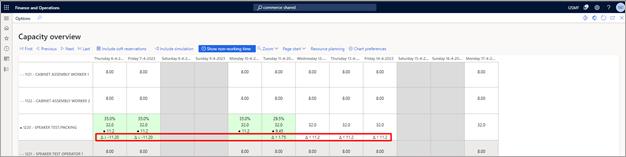

When including the simulation, the capacity overview gets updated according to the changes made in the production simulation.

Changes caused by the simulation via the removal or addition of hours to resource group(s) and or resource(s) are indicated by the delta icon under the scheduled effort.

When including the simulation, the percentage of utilization is updated based on the resource requirement of the simulation.

Calendar

Description automatically generated with low confidence

Any change will be shown via the following indicators:

Text

Description automatically generated with medium confidence

Indicating that hours are removed with the reduced amount.

Graphical user interface

Description automatically generated with medium confidence

Indicating that hours are added with the assigned amount.

Simulate calendar deviations in production planning simulation

Calendar simulations are available in the fact pane when a resource is selected.

A screenshot of a computer

Description automatically generated

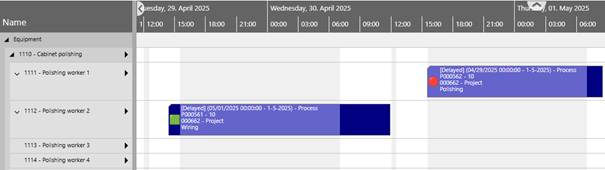

When selecting calendar deviations, it is possible to change the calendar for the selected resource.

A screenshot of a computer

Description automatically generated

The Calendar deviation will only be visible in the simulation and can be applied on the actual calendar of the resource when publishing the simulation. Using the "Adjust calendars" action, allows to apply another calendar to multiple, selected, days.

A screenshot of a computer

Description automatically generated

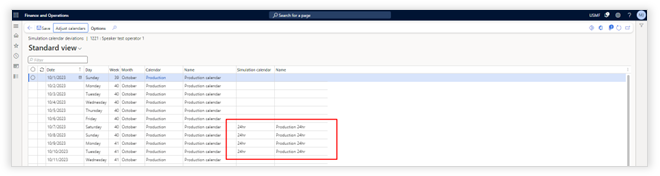

Calendar deviations are noted in both the Planning action log within the simulation and the Planning action log of the resource planning when the simulation is published.

A screenshot of a computer

Description automatically generated

A screenshot of a computer

Description automatically generated

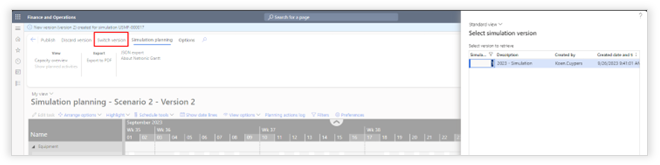

New production planning simulation version(s)

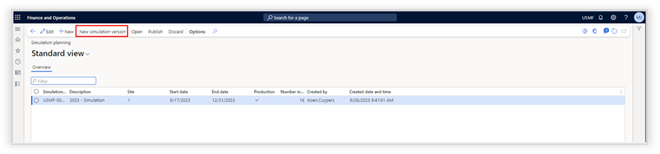

Creating new versions of the simulation planning can be done by using the "New simulation version" icon:

A screenshot of a computer

Description automatically generated

A new version can be created based on the actual planning or from the already existing simulation.

Once a new version is created it is possible to switch between versions by using the "Switch version" icon.

A screenshot of a computer

Description automatically generated
